MVP vs Prototype vs POC: What You Actually Need in 2026
The short answer: Most founders who think they need an MVP actually need a prototype. Most who think they need a prototype actually need a conversation with 10 potential customers. And most who think they need a POC need to stop trying to convince their boss and start showing them.
Here’s the framework for picking the right one — and not wasting 3 months building something nobody asked for.
The Real Definitions (Skip the Textbook)
Every blog post about this topic gives you the same Wikipedia-level definitions. Let me tell you what these actually mean when you’re spending real money.
Proof of Concept (POC): “Can this even work?”
What it is: The smallest possible test to prove a technical or business assumption.
Real example: Before we built a GPS device at ₹700 (when the market charged ₹4,000), we first wired together a $3 SIM800L module, a GPS antenna, and an Arduino on a breadboard. Total cost: ₹500 and a weekend. That breadboard proved the core tech worked before we spent a single rupee on PCB design.
You need a POC when:
- Your idea depends on something technically unproven
- Stakeholders need proof before approving budget
- You’re combining technologies that haven’t been combined before
- The biggest risk is “can we actually build this?” not “will anyone use it?”
Cost: ₹0-50K | Time: 1-2 weeks | What you get: A yes/no answer
What a POC is NOT: Something you show to customers. A POC can be ugly, hacky, held together with duct tape. It answers one question: does the core mechanism work?
Prototype: “Is this the right thing to build?”
What it is: A clickable, testable version that looks and feels like the real product — but doesn’t actually work under the hood.
Real example: When we built the manufacturing OS for a $24M textile company, we didn’t start coding. We built clickable Figma screens, put them on tablets, and watched factory supervisors try to use them. In 3 days, we learned that supervisors wouldn’t type — they needed QR codes and tap-only interfaces. That insight saved 2 months of wrong development.
You need a prototype when:
- You know the tech works, but you’re not sure about the UX
- You need user feedback before investing in development
- You’re pitching investors and need something to demo
- You have 3 ideas and need to pick one
Cost: ₹10K-1L | Time: 1-3 weeks | What you get: User reactions, validated UX, investor demo
What a prototype is NOT: Production code. Don’t write backend logic for a prototype. Use Figma, Framer, or a no-code tool. If you’re writing code at this stage, you’re going too fast.
MVP (Minimum Viable Product): “Will people pay for this?”
What it is: The smallest real product that delivers enough value that someone will pay for it (or commit real time to using it).
Real example: UTMStamp launched in 13 days. Not 13 days to a prototype — 13 days to a live product with real users creating real email signatures with real UTM tracking. No analytics dashboard (came later). No team management (came later). Just: create signature → add UTM → copy to email. That’s it. That was the MVP.
You need an MVP when:
- Your prototype tested well and you’re ready to build
- You’ve validated demand (conversations, waitlist, pre-orders)
- The biggest risk is “will people use this in real life?” not “is this the right idea?”
- You need revenue or traction data for investors
Cost: ₹1-10L | Time: 4-12 weeks | What you get: Real users, real data, real feedback
What an MVP is NOT: A half-built version of your grand vision. An MVP is a complete product that does one thing well. Not a broken product that does ten things poorly.
The Decision Framework
Stop thinking about what to build. Start thinking about what you need to learn.

What’s your biggest risk right now?

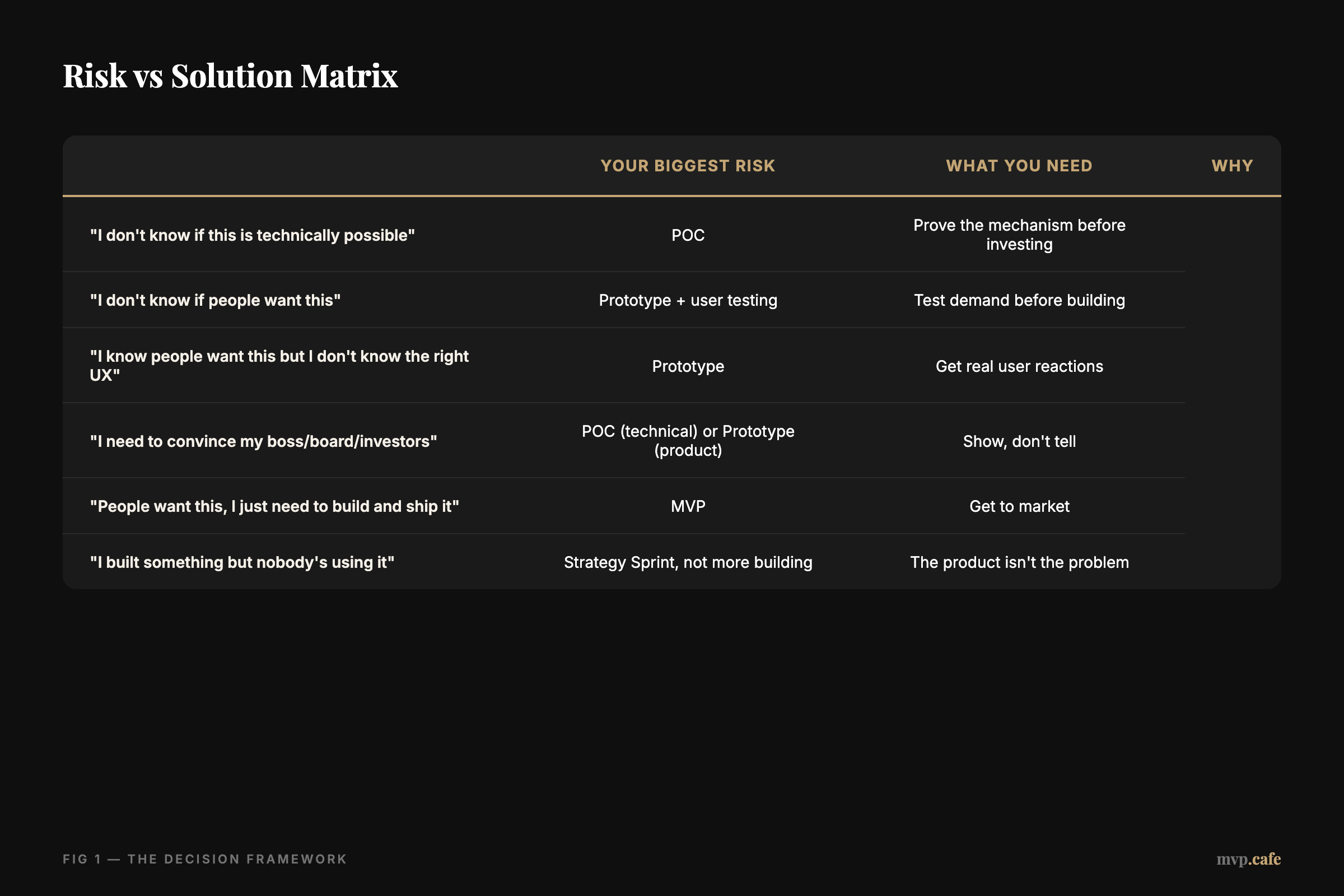

| Your biggest risk | What you need | Why |
|---|---|---|
| ”I don’t know if this is technically possible” | POC | Prove the mechanism before investing |
| ”I don’t know if people want this” | Prototype + user testing | Test demand before building |
| ”I know people want this but I don’t know the right UX” | Prototype | Get real user reactions |
| ”I need to convince my boss/board/investors” | POC (technical) or Prototype (product) | Show, don’t tell |
| ”People want this, I just need to build and ship it” | MVP | Get to market |
| ”I built something but nobody’s using it” | Strategy Sprint, not more building | The product isn’t the problem |
The 2026 Twist: AI Changed the Math
Here’s what’s different now. In 2024, an MVP cost ₹5-15L and took 3-6 months. In 2026:
- POC: Often free. ChatGPT can prototype logic. Claude can write the algorithm. You can test feasibility in an afternoon.
- Prototype: Cursor, Lovable, Bolt, or Replit can generate a working prototype in hours. But “working” and “production-ready” are very different things.
- MVP: AI tools get you to 80% in a weekend. The last 20% — auth, payments, security, deployment, error handling — still takes 4-8 weeks of real engineering.
The dangerous part: AI tools blur the line between prototype and MVP. Founders build something that looks like a product, feels like a product, but breaks the moment real users touch it. That’s not an MVP. That’s a prototype pretending to be one.
Based on our analysis of 45+ product builds, the #1 mistake in 2026 is skipping the prototype stage. Founders go straight from idea to AI-coded “MVP” without testing whether anyone wants it. They ship in a weekend, get zero users, and conclude the idea was bad. The idea might have been fine — they just skipped validation.
The Build Order (When You Have No Idea Where to Start)
Week 1: Talk to 10 people. Not surveys. Not forms. Real conversations. “Would you pay ₹X for something that does Y?” If 7+ say yes, proceed.
Week 2: Prototype. Figma, Lovable, or even a slide deck. Show it to the same 10 people. Watch their faces when they use it. Faces don’t lie — words do.
Week 3-4: POC (if needed). Only if there’s a technical risk. Most B2B SaaS and consumer apps don’t need a POC — the tech is proven. If you’re doing IoT, AI/ML, or hardware, POC is mandatory.
Week 5-12: MVP. Build the smallest thing that delivers the core value. Ship it. Charge for it. Iterate based on real usage data, not hypotheses.
Total time to market: 5-12 weeks. Total wasted effort: close to zero, because every stage validated the next.

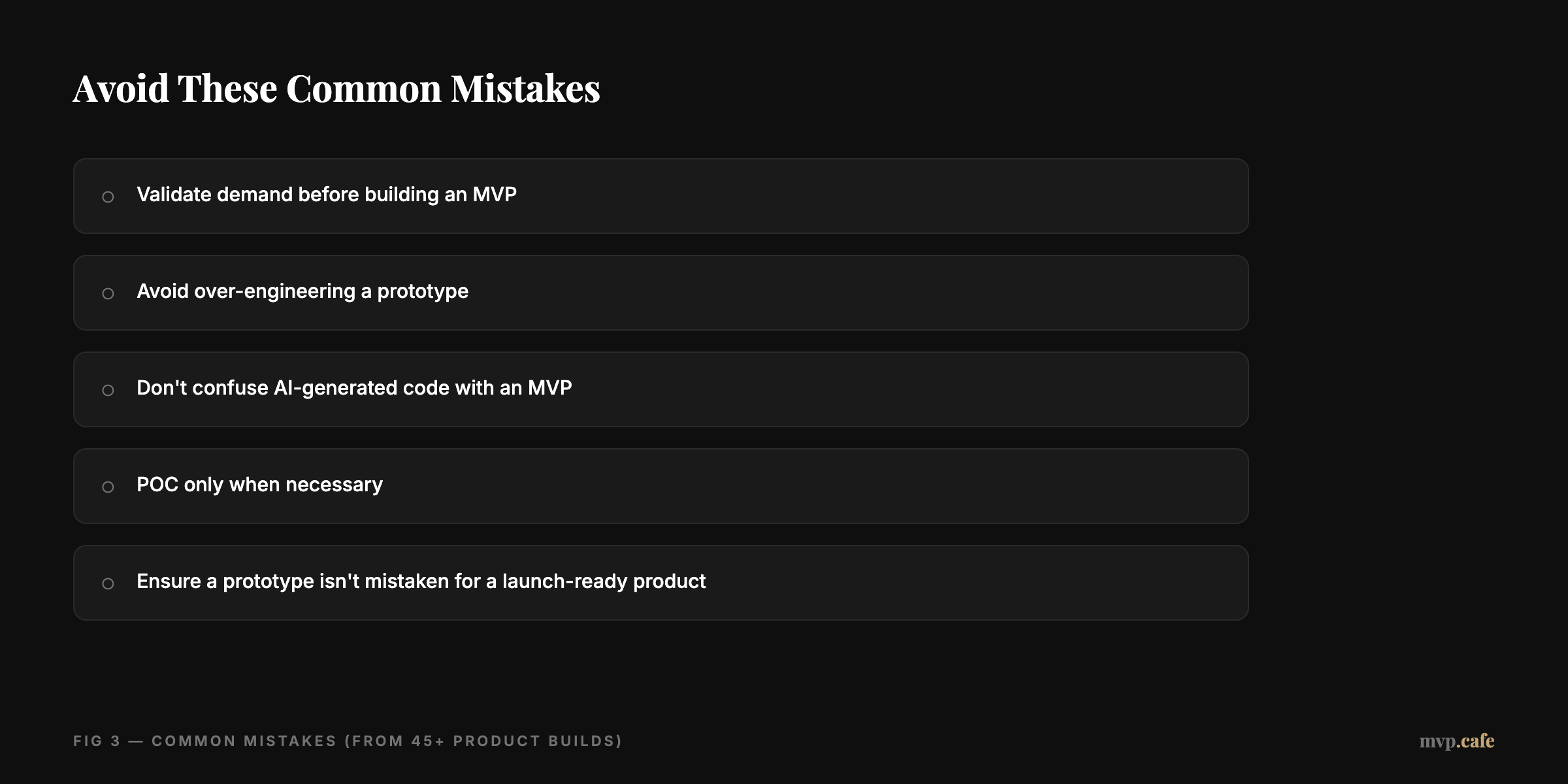

Common Mistakes (From 45+ Product Builds)
Mistake 1: Building an MVP without validating demand
What happens: 3 months of development. Zero users. “The market wasn’t ready.” The fix: Talk to humans first. Always. No exceptions.

Mistake 2: Over-engineering a prototype
What happens: “Let me just add auth and payments to the prototype.” Now it’s 6 weeks in and you’ve built something nobody tested. The fix: Prototype = no backend code. Period. If your prototype needs real code, you’ve skipped a step.
Mistake 3: Confusing AI-generated code with an MVP
What happens: Cursor built your app in a weekend. You deploy it. API keys exposed, no rate limiting, database is SQLite in /tmp. The fix: AI-generated code is a prototype. Treat it as one. Budget 4-8 weeks to make it production-ready. (See our 15-point production checklist.)
Mistake 4: POC-ing what doesn’t need a POC
What happens: “Let me build a POC for my CRM.” A CRM is a solved problem. You don’t need to prove it’s technically possible. You need to prove your version is different enough that people switch. The fix: POC is for unproven tech. For proven tech, skip straight to prototype + user testing.
Mistake 5: Shipping a prototype and calling it launched
What happens: 50 sign-ups on launch day. 47 churn in a week because the app crashes, loads slowly, or looks broken on mobile. The fix: If it’s not stable under 100 concurrent users, it’s not an MVP. It’s a demo.

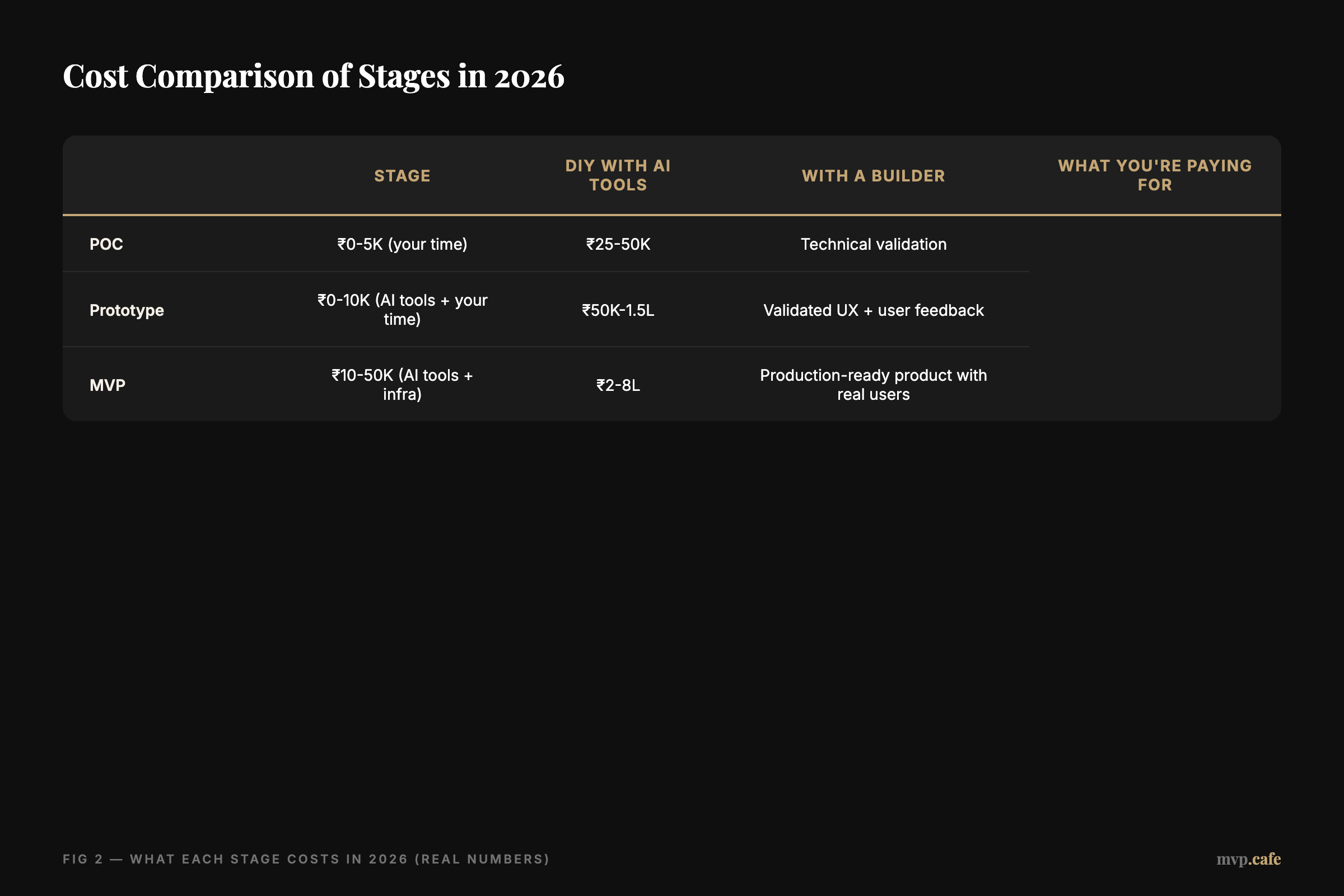

What Each Stage Costs in 2026 (Real Numbers)
| Stage | DIY with AI Tools | With a Builder | What You’re Paying For |
|---|---|---|---|
| POC | ₹0-5K (your time) | ₹25-50K | Technical validation |
| Prototype | ₹0-10K (AI tools + your time) | ₹50K-1.5L | Validated UX + user feedback |
| MVP | ₹10-50K (AI tools + infra) | ₹2-8L | Production-ready product with real users |

The gap between “DIY with AI” and “with a builder” isn’t just money — it’s quality. A ₹0 Cursor prototype might look identical to a ₹1L professionally built one. The difference shows up at 100 users, not 1.
The Question That Actually Matters
Forget “should I build an MVP or prototype?” The real question is:
What do you need to learn next?
If the answer is “whether anyone wants this” → prototype + conversations. If the answer is “whether this tech works” → POC. If the answer is “whether this can be a business” → MVP. If the answer is “I already launched and nobody came” → you don’t need to build anything. You need a strategy.
Not Sure Where You Are?
Take the Build Score — it’s free, takes 3 minutes, and tells you exactly which stage you’re at and what to do next. No email required to see your results.
Or if you already know what you need: book a Coffee Chat — 15 minutes, no commitment, we’ll tell you honestly if we can help.
At mvp.cafe, we’ve shipped 45+ products across every stage — from napkin-sketch POCs to full production MVPs. We’ve seen what works, what wastes money, and where founders get stuck. That’s why we built the Build Score: so you don’t have to guess where you are.
FAQ
Can I skip the prototype and go straight to MVP?
Only if you’ve already validated demand through conversations, a waitlist, or pre-orders. If you’re going off your own intuition, build a prototype first. Your intuition is probably wrong — ours was, 6 times out of 10.
Is a landing page a prototype or an MVP?
Neither — it’s a demand test. A landing page with a waitlist tests whether people want the thing. It doesn’t test whether the thing works (prototype) or whether people will pay for it (MVP). But it’s a great first step.
My AI-built app already has real users. Is it an MVP?
If it’s stable, secure, and people keep coming back — yes. If it crashes twice a week and you’re manually fixing the database — it’s a prototype that you launched too early. No shame in that. Most AI-built apps are in this category.
How do I know when my MVP is “minimum” enough?
If you can describe what it does in one sentence and a user can get value from it in under 5 minutes — it’s minimum enough. If you need a paragraph to explain it, you’re building too much.
What’s a Strategy Sprint?
A 2-week structured engagement (₹16,000) where we help you figure out exactly what to build, what to skip, and how to get your first 100 users. It’s the fastest way to go from “I have an idea” to “I have a plan.” Learn more →
